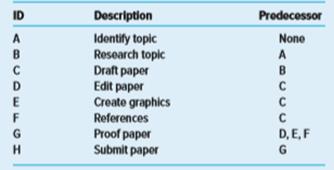

Draw a project network from the following information. What activity (ies) is a burst activity? What activity (ies) is a merge activity?

ID Description Prodecessor A Identify topic Research topic Draft paper Edit paper Create graphics None B A D E F References Proof paper Submit paper D, E, F G BCC
> Select the most appropriate answer for each of the following questions. 1. Goodwill is a. Seldom reported because it is too difficult to measure. b. Reported when more than book value is paid in purchasing another company. c. Reported when the fair value
> Most subsidiaries are wholly owned, although only majority ownership is usually all that is required for consolidation. The parent’s ownership may be direct or indirect. Frequently, a parent’s direct subsidiaries have subsidiaries of their own, thus prov
> Top Corporation acquired 100 percent of Sun Corporation’s common stock on December 31, 20X2. Balance sheet data for the two companies immediately following the acquisition follow: At the date of the business combination, the book valu
> Astor Corporation’s balance sheet at January 1, 20X7, reflected the following balances: Phel Corporation, which had just entered into an active acquisition program, acquired 100 percent of Astor’s common stock on Jan
> Gold Enterprises acquired 100 percent of Premium Builders’ stock on December 31, 20X4. Balance sheet data for Gold and Premium on January 1, 20X5, are as follows: At the date of the business combination, Premium’s ca
> Blank Corporation acquired 100 percent of Faith Corporation’s common stock on December 31, 20X2, for $189,000. Data from the balance sheets of the two companies included the following amounts as of the date of acquisition: At the date
> Road Corporation acquired all of Conger Corporation’s voting shares on January 1, 20X2, for $470,000. At that time Conger reported common stock outstanding of $80,000 and retained earnings of $130,000. The book values of Conger’s assets and liabilities a
> Reed Corporation acquired 100 percent of Thorne Corporation’s voting common stock on December 31, 20X4, for $395,000. At the date of combination, Thorne reported the following: At December 31, 20X4, the book values of Thorneâ
> Crumple Car Rentals is planning to expand into the western part of the United States and needs to acquire approximately 400 additional automobiles for rental purposes. Because Crumple’s cash reserves were substantially depleted in replacing the bumpers o
> On June 10, 20X8, Tower Corporation acquired 100 percent of Brown Company’s common stock. Summarized balance sheet data for the two companies immediately after the stock acquisition are as follows: Required a. Give the consolidation
> Turner Corporation reported the following balances at January 1, 20X9: On January 1, 20X9, Gross Corporation purchased 100 percent of Turner’s stock. All tangible assets had a remaining economic life of 10 years at January 1, 20X9. Bo
> Rod Corporation purchased 100 percent ownership of Stafford Corporation on January 1, 20X4, for $65,000, which was $10,000 above the underlying book value. Half the additional amount was attributable to an increase in the value of land held by Stafford,
> During review of the adjusting entries to be recorded on December 31, 20X8, Grand Corporation discovered that it had inappropriately been using the cost method in accounting for its investment in Case Products Corporation. Grand purchased 100 percent own
> Branch Corporation purchased 100 percent of Hardy Company’s common stock on January 1, 20X5, and paid $28,000 above book value. The full amount of the additional payment was attributed to amortizable assets with a life of eight years remaining at January
> Brindle Company purchased 100 percent of Monroe Company’s voting common stock for $648,000 on January 1, 20X4. At that date, Monroe reported assets of $690,000 and liabilities of $230,000. The book values and fair values of Monroe’s assets were equal exc
> Capital Corporation purchased 100 percent of Cook Company’s stock on January 1, 20X4, for $340,000. On that date, Cook reported net assets with a historical cost of $300,000 and a fair value of $340,000. The difference was due to the increased value of b
> Best Corporation acquired 100 percent of the voting common stock of Flair Company on January 1, 20X7, by issuing bonds with a par value and fair value of $670,000 and making a cash payment of $24,000. At the date of acquisition, Flair reported assets of
> Power Corporation purchased 100 percent of the common stock of Snow Corporation on January 1, 20X2, by issuing 45,000 shares of its $6 par value common stock. The market price of Power’s shares at the date of issue was $24. Snow reported net assets with
> Roller Corporation purchased 100 percent ownership of Steam Company on January 1, 20X5, for $270,000. On that date, the book value of Steam’s reported net assets was $200,000. The excess over book value paid is attributable to depreciab
> Although Sloan Company had good earnings reports in 20X5 and 20X6, it had a negative retained earnings balance on December 31, 20X6. Jacobs Corporation purchased 100 percent of Sloan’s common stock on January 1, 20X7. a. Explain how Sloan’s negative reta
> What portion of the book value of the net assets held by a subsidiary at acquisition is included in the consolidated balance sheet?
> Turner Manufacturing Corporation owns 100 percent of the common shares of Straight Lace Company. If Straight Lace reports net income of $100,000 for 20X5, what factors may cause Turner to report less than $100,000 of income from the investee?
> What is a differential? How is a differential treated by an investor in computing income from an investee under (a) cost-method and (b) equity-method reporting?
> When is the carrying value of the investment account reduced under equity-method reporting?
> What happens to the differential when push-down accounting is used following a business combination?
> What does the term push-down accounting mean?
> What determines whether the balance assigned to the differential remains constant or decreases each period?
> Explain why consolidated financial statements become increasingly important when the differential is very large.
> What happens to the differential in the consolidation worksheet prepared as of the date of combination? How is it reestablished so that the proper balances can be reported the following year?
> What portion of the fair value of a subsidiary’s net assets normally is included in the consolidated balance sheet following a business combination?
> Ball Corporation’s owners recently offered to sell 100 percent of their ownership to Timber Corporation for $450,000. Timber’s business manager was told that Ball’s book value was $300,000, and she estimates the fair value of its net assets at approximat
> What conditions must exist for a negative differential to occur?
> What is the term differential used to indicate?
> Under what conditions is push-down accounting considered appropriate?
> When Ajax was preparing its consolidation worksheet, the differential was properly assigned to buildings and equipment. What additional entry generally must be made in the worksheet?
> Give a definition of consolidated net income.
> Select the correct answer for each of the following questions. 1. On January 1, 20X1, Prim Inc. acquired all of Scrap Inc.’s outstanding common shares for cash equal to the stock’s book value. The carrying amounts of Scrap’s assets and liabilities approx
> On April 1, 20X8, Plum Inc. paid $1,700,000 for all of Long Corp.’s issued and outstanding common stock. On that date, the costs and fair values of Long’s recorded assets and liabilities were as follows: In Plum&acir
> Consolidated financial statements are being prepared for a parent and its four wholly owned subsidiaries that have intercompany loans of $100,000 and intercompany profits of $300,000. How much of these intercompany loans and profits should be eliminated?
> The first examination of Rudd Corporation’s financial statements was made for the year ended December 31, 20X8. The auditor found that Rudd had acquired another company on January 1, 20X8, and had recorded goodwill of $100,000 in connec
> Nugget Company’s balance sheet on December 31, 20X6, was as follows: On December 31, 20X6, Gold Company acquired all of Nugget’s outstanding common stock for $1,500,000 cash. On that date, the fair (market) value of
> The reporting treatment for investments in common stock depends on the level of ownership and the ability to influence the investee’s policies. The reporting treatment may even change over time as ownership levels or other factors change. When investees
> The Global Tea and Organic Juice companies have merged. The following information has been collected for the “Consolidation Project.” 1. Compute the expected time for each activity. 2. Compute the variance for each
> Given the project information below, what is the probability of completing the National Holiday Toy project in 93 time units? Act. ID Doscription Prodocossor Optm. (a) Most likoly (m) Pess. (b) Act timo t, Varlance ((b– ay6 Critical Design package
> Why are lags used in developing project networks?
> Why is slack important to the project manager?
> The project information for the custom order project of the Air Control Company is presented here. Draw a project network for this project. Compute the early and late activity times and the slack times. Identify the critical path. ID Descriptlon Pre
> From the following information, develop an AON project network. Complete the forward and backward pass, compute activity slack, and identify the critical path. How many days will the project take? ID Description Predecessor Time Survey site Excavate
> Draw a project network from the following information. What activity (ies) is a burst activity? What activity (ies) is a merge activity? ID Description Prodecessor Contract signed Survey designed Target market identified Data collection A None B B D
> Given the network below, compute the early, late, and slack time for each activity. Clearly identify the critical path. Lag 1 E Build Cabinets Install Cabinets 7 A Lag 5 Design 3 Tear Down G Install Appliances Lag 2 Inspect 2 Lag 5 Order Ap
> Given the following information, compute the early, late, and slack times for the project network. Which activities on the critical path have only the start or finish of the activity on the critical path? Lahes Lag Pave Post Signs Signng
> You have prepared the following schedule for a project in which the key resource is a backhoe(s). This schedule is contingent on having 3 backhoes. You receive a call from your partner, Brooker, who desperately needs one of your backhoes. You tell Brooke
> You are creating a database for the Oklahoma City Thunder NBA Basketball team. Given the project network that follows, complete the forward and backward pass, compute activity slack, and identify the critical path. Use this information to create a Gant
> A large Southeast city is requesting federal funding for a park-and-ride project. One of the requirements in the request application is a network plan for the design phase of the project. Sophie Kim, the chief engineer, wants you to develop a project net
> K. Nelson, project manager of Print Software, Inc., wants you to prepare a project network; compute the early, late, and slack activity times; determine the planned project duration; and identify the critical path. His assistant has collected the followi
> You are creating a customer database for the Hillsboro Hops minor league baseball team. Draw a project network given the information in the table that follows. Complete the forward and backward pass, compute activity slack, and identify the critical path
> You have signed a contract to build a garage for the Simpsons. You will receive a $500 bonus for completing the project within 17 working days. The contract also contains a penalty clause in which you will lose $100 for each day the project takes longer
> How does the WBS differ from the project network?
> What is a hammock activity, and when is it used?
> What is the difference between free slack and total slack?
> Why bother creating a WBS? Why not go straight to a project network and forget the WBS?
> How are WBS and project networks linked?
> Review the front page of your local newspaper, and try to identify all the projects contained in the articles. How many were you able to find?
> You are creating a customer database for the Lehigh Valley IronPigs minor league baseball team. Draw a project network given the information below. Complete the forward and backward pass, compute activity slack, and identify the critical path. How lo
> Here is a partial work breakdown structure for a wedding. Use the method described in the Snapshot from Practice 6.1: The Yellow Sticky Approach to create a network for this project. Do not include summary tasks in the network (i.e., 1.3, Ceremony, is a
> The CyClon project team has started gathering information necessary to develop a project network—predecessor activities and activity time in days. The results of their meeting are found in the following table: Part A. Create a netwo
> The optical disk project team has started gathering the information necessary to develop the project network—predecessor activities and activity times in weeks. The results of their meeting are found in the following table The project
> Using Microsoft Project, set up the network and determine the critical path for Phase 1 of the Whistler Ski Resort project. The project workweek will be 5 days (M–F). Whistler Ski Resort Project Given the fact that the number of skiing visitors to Whis
> The planning department of an electronics firm has set up the activities for developing and production of a new MP3 Player. Given the information below, develop a project network using Microsoft Project. Assume a five-day workweek and the project starts
> You are managing a product upgrade project for Bangkokagogo. Given the project network that follows, complete the forward and backward pass, compute activity slack, and identify the critical path. Use this information to create a Gantt chart for the proj
> The G&E Company is preparing a bid to build the new 47,000-seat Shoreline baseball stadium. The construction must start on July 3, 2017, and be completed in time for the start of the 2020 season. A penalty clause of $250,000 per day of delay beyond A
> Brian Smith, network administrator at Advanced Energy Technology (AET), has been given the responsibility of implementing the migration of a large data center to a new office location. Careful planning is needed because AET operates in the highly competi
> How does the culture of an organization influence the quality of estimates?
> Develop a resource schedule in the loading chart that follows. Use the parallel method and heuristics given. Be sure to update each period as the computer would do. Note: activities 2, 3, 5, and 6 use two of the resource skills. Three of the resource sk
> Exercise Figure 5.1 is a project WBS with cost apportioned by percentages. If the total project cost is estimated to be $600,000, what are the estimated costs for the following deliverables? a. Design b. Programming c. In-house testing. What weaknesse
> What are the differences between bottom-up and top-down estimating approaches? Under what conditions would you prefer one over the other?
> Why are accurate estimates critical to effective project management?
> Why is it difficult to estimate mega project (e.g., airports, stadiums, etc.) costs and benefits?
> What are the major types of costs? Which costs are controllable by the project manager?
> Calculate the direct cost of labor for a project team member using the following data: Hourly rate: $40/hr Hours needed: 80 Overhead rate: 40%
> Firewall Project XT. Using the “complexity weighting” scheme shown in Table 5.3 and the function point complexity weight table shown below, estimate the total function point count. Assume historical data suggest five f
> Mrs. Tolstoy and her husband, Serge, are planning their dream house. The lot for the house sits high on a hill with a beautiful view of the Appalachian Mountains. The plans show the size of the house to be 2,900 square feet. The average price for a lot a
> Josh and Mike met each other as roommates during freshman year at MacAlister College in St. Paul, Minnesota. Despite a rocky start they became best friends. They are planning on going on a two-week adventure together to celebrate their graduation in June
> Check out the Project Management Institute’s home page at www.pmi.org. a. Review general information about PMI as well as membership information. b. See if there is a PMI chapter in your state. If not, where is the closest one? c. Use the search functi
> Three years ago the Sharp Printing (SP) strategic management group set a goal of having a color laser printer available for the consumer and small business market for less than $200. A few months later the senior management met off-site to discuss the ne
> NSDC has a contract to produce eight satellites to support a worldwide telephone system (for Alaska Telecom, Inc.) that allows individuals to use a single, portable telephone in any location on earth to call in and out. NSDC will develop and produce the
> What does it mean if the priorities of a project include: Time-constrain, Scopeaccept, and Cost-enhance?
> What questions does a project objective answer? What would be an example of a good project objective?
> What are the six elements of a typical scope statement?
> When would it be appropriate to create a responsibility matrix rather than a fullblown WBS?
> How does a communication plan benefit management of projects?
> What kinds of information are included in a work package?
> In small groups, identify real life examples of a project that would fit each of the following priority scenarios: Time-constrain, Scope-enhance, Cost-accept Time-accept, Scope-constrain, Cost-accept Time-constrain, Scope-accept, Cost-enhance
> You are in charge of organizing a dinner-dance concert for a local charity. You have reserved a hall that will seat 30 couples and have hired a jazz combo. a. Develop a scope statement for this project that contains examples of all the elements. Assume
> You have prepared the following schedule for a project in which the key resource is a tractor(s). There are three tractors available to the project. Activities A and D require one tractor to complete while activities B, C, E, and F require 2 tractors. D
> Develop a WBS for a local stage play. Be sure to identify the deliverables and organizational units (people) responsible. How would you code your system? Give an example of the work packages in one of your cost accounts. Develop a corresponding OBS which
> Develop a WBS for a project in which you are going to build a bicycle. Try to identify all of the major components and provide three levels of detail.
> Nicolette Larson was loading the dishwasher with her husband, Kevin, and telling him about the first meeting of the Manchester United Tournament Organizing Committee. Nicolette, a self-confessed “soccer mom,” had been elected tournament director and was
> Lukas Nelson and his wife, Anne, and their three daughters had been living in their house for over five years when they decided it was time to make some modest improvements. One area they both agreed needed an upgrade was the bathtub. Their current house
> This chapter discussed the role of values and beliefs in forming an organization’s culture. The topic of organizational culture is big business on the Internet. Many companies use their Web pages to describe their mission, vision, and c
