2.99 See Answer

Question: Consider the project network below. Suppose the

Consider the project network below. Suppose the duration of both activities A and D can be reduced to 1 day, at a cost of $15 per day of reduction. Also, activities E, G, and H can be reduced in duration by 1 day, at a cost of $25 per day of reduction. What is the least-cost approach to crash the project 2 days? What is the shortest “crashed” duration, the new critical path, and the cost of crashing?
Consider the project network below. Suppose the duration of both activities A and D can be reduced to 1 day, at a cost of $15 per day of reduction. Also, activities E, G, and H can be reduced in duration by 1 day, at a cost of $25 per day of reduction. What is the least-cost approach to crash the project 2 days? What is the shortest “crashed” duration, the new critical path, and the cost of crashing?





Transcribed Image Text:

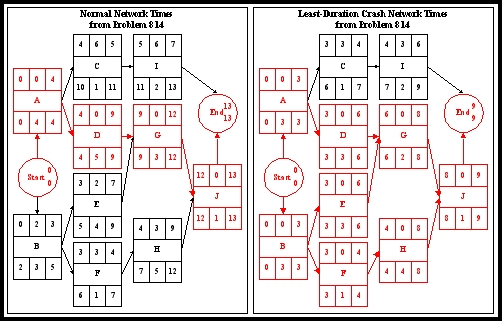

Nomal Network Times Least-Dration Crash Network Tme fra ΕrobMan 3 14 τη Εroblen 8 14 567 3 34 I I 4 10 1 11 11 | 2 13 6 1|7 7 2 9 A A 13 0 12 306 6. End 4 4 33 G D 93 12 628 6 Sta rt 12 0 13 Sta rt 3 2 7 30 6 J 12 1 13 1 3 4 336 B 3 2 3 5 7s 12 033 44 6 1 7 3 1 4


> A company has established a project team to identify a location for a new manufacturing facility. Use a weighted scoring model to analyze three candidate locations (A, B, C) for setting up the new factory. The relative weights for each criterion are show

> A four-year financial project is forecast to have net cash inflows of $20,000; $25,000; $30,000; and $50,000 in the next four years. It will cost $75,000 to implement the project, payable at the beginning of the project. If the required rate of return is

> What do you suggest Mr. Lament do, if anything, to begin his preparation for defending or settling this potential lawsuit?
