Refer to the table in Problem 3.3.

a) Draw the AON network for the construction activity.
b) Draw the AOA network for the construction activity.

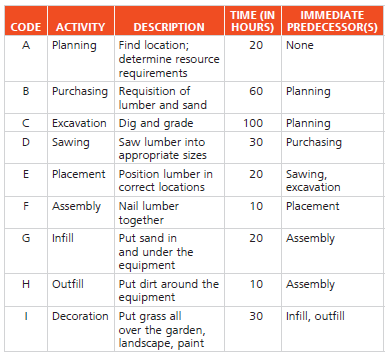

TIME (IN HOURS) PREDECESSOR(S) IMMEDIATE CODE ACTIVITY DESCRIPTION Planning Find location; determine resource A 20 None requirements Purchasing Requisition of lumber and sand B 60 Planning Excavation Dig and grade 100 Planning D Sawing Saw lumber into 30 Purchasing appropriate sizes Placement Position lumber in correct locations Sawing, excavation E 20 Assembly Nail lumber together F 10 Placement G Infll Put sand in 20 Assembly and under the equipment Outfill Put dirt around the 10 Assembly equipment Decoration Put grass all over the garden, landscape, paint 30 Infill, outfill
