Three activities are candidates for crashing on a project network for a large computer installation (all are, of course, critical). Activity details are in the following table:
a) What action would you take to reduce the critical path by 1 day? b) Assuming no other paths become critical, what action would you take to reduce the critical path one additional day? c) What is the total cost of the 2-day reduction?

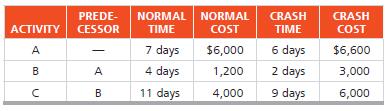

PREDE- NORMAL NORMAL CRASH CRASH ACTIVITY CESSOR TIME COST TIME COST 7 days $6,000 6 days $6,600 A 2 days 9 days B A 4 days 1,200 3,000 11 days 6,000 B. 4,000
