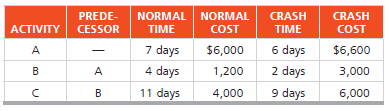

Three activities are candidates for crashing on a project network for a large computer installation (all are, of course, critical). Activity details are in the following table:

a) What action would you take to reduce the critical path by 1 day?
b) Assuming no other paths become critical, what action would you take to reduce the critical path one additional day?
c) What is the total cost of the 2-day reduction?
PREDE- NORMAL NORMAL CRASH CRASH ACTIVITY CESSOR TIME COST TIME COST 7 days 6 days 2 days 9 days A $6,000 $6,600 В A 4 days 1,200 3,000 В 11 days 4,000 6,000 B.
